How_do_I_final_close_a_job_2025.02_

How do I final close a job? (2025.02)

Permanently close a job.

You would final close a job in Caselle Project Management when all project work and financial activity have been completed. Final closing prevents additional transactions from being posted to the job and indicates that the project is officially finished. This helps maintain accurate financial records, ensures completed jobs are no longer used in error, and supports cleaner reporting and year-end processing.

After you complete a preliminary close, the next step is to perform a final close. Use Close Job - Final to prevent users from making changes to the job, including adding information, changing details, or removing information. Running Close Job - Final will create the corresponding entries in the General Ledger, update pending assets in Asset Management, and change the job status to closed.


When you final close a job, you cannot not
  • Add new information to a closed job.

  • Change properties on a closed job.

  • Remove information from a closed job.


When you final close a job, you can
  • View actual job costs.

  • Add or change asset information.

  • Print closing reports.



Create the corresponding entries in the General Ledger, update pending assets in Asset Management, and change the job status to closed.




 Before you get started

  • Before proceeding, back up the current files. Always make a back up of the database BEFORE running routines that modify or delete transactions. See the help topic titled How do I back up a database?




Step 1. Preview preliminary close jobs

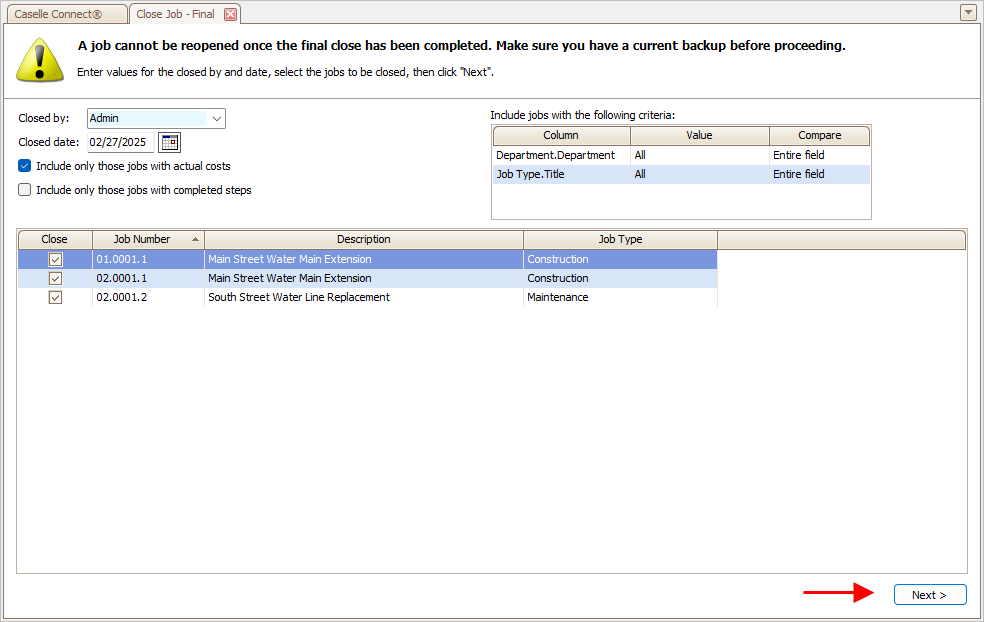

1. Open Connect Project Accounting > Jobs > Close Job - Final.

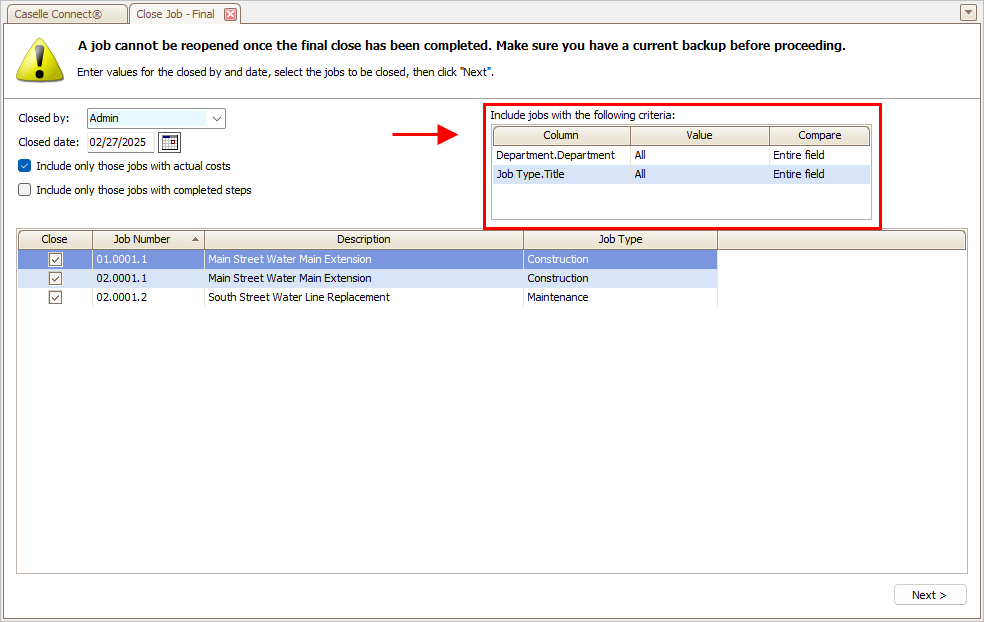

2. Fill in the Closed By, Closed Date, and Include Only fields.

The transaction grid will show preliminary close jobs. To filter the list of preliminary close jobs, use the Include Jobs With the Following Criteria.





3. Click .

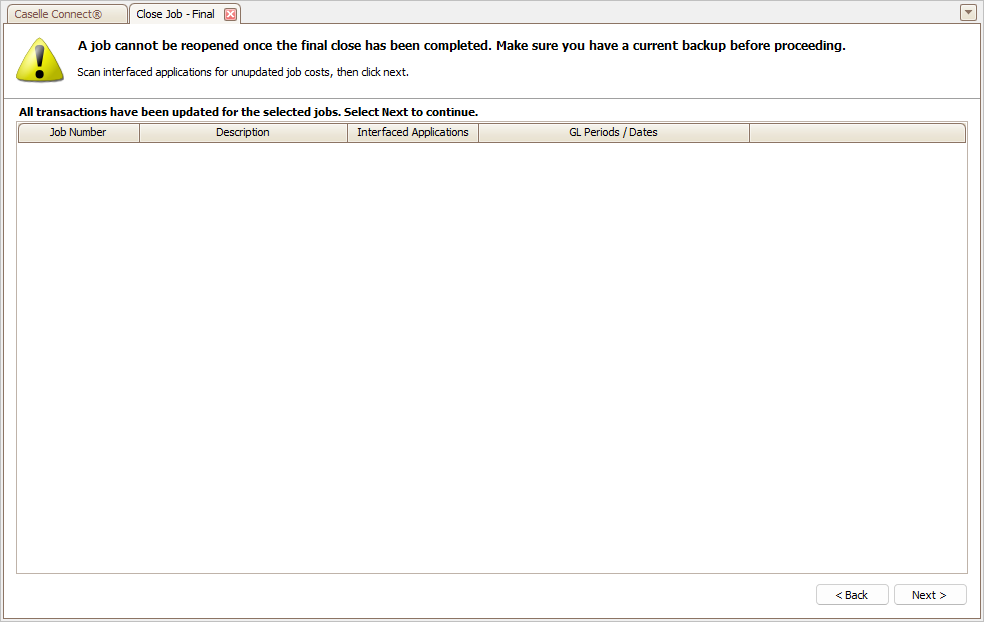

Step 2. Scan for unupdated job costs

This view shows transactions in other subsystems (Asset Management, Materials Management, and so on) that have not been updated to Project Accounting. Scan the list for job costs that have not been updated to Project Accounting.




Do unupdated job costs exist?

  • Yes, unupdated job costs exist. You'll need to update the unupdated job costs to the General Ledger, run Update Project Accounting. When you're done, return to this view and click Reload Data (CTRL+R) to update the transaction grid.

  • No, unupdated job costs do not exist. Click  to continue.

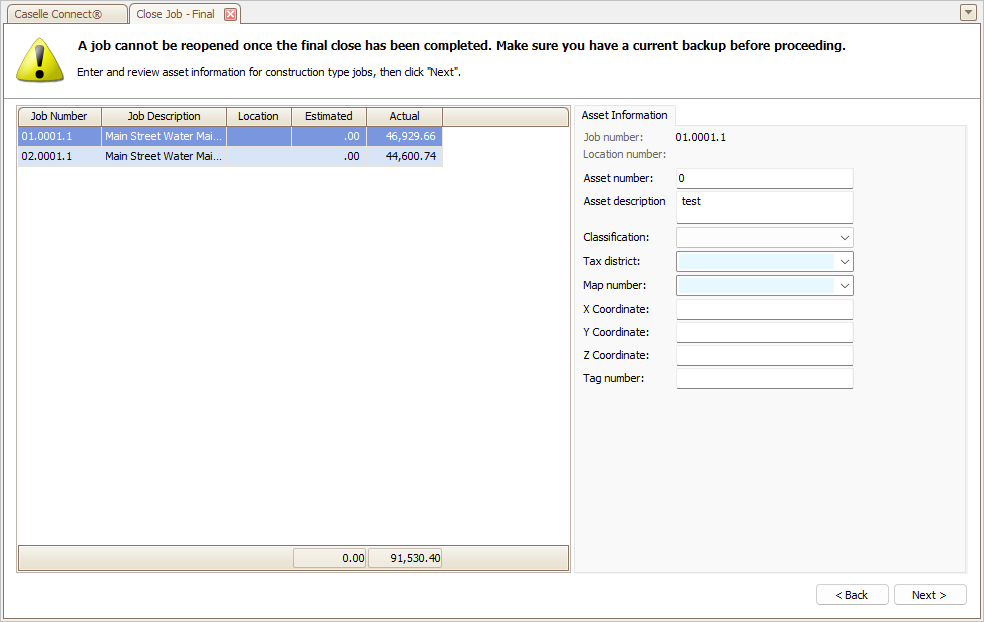

Step 3. Review asset information for construction type jobs

Asset information refers to the assets that are acquired, used, or created during the project. Review the asset information, estimated costs, and actual costs.





Are the costs correct?

  • Yes, the costs for maintenance jobs are correct. Click .

  • No, the costs for maintenance jobs are NOT correct. Use Connect Project Accounting > Jobs > Modify Existing Jobs to enter the correct amounts. Then, click Reload Data (CTRL+R) to update the information in Close Jobs - Final.

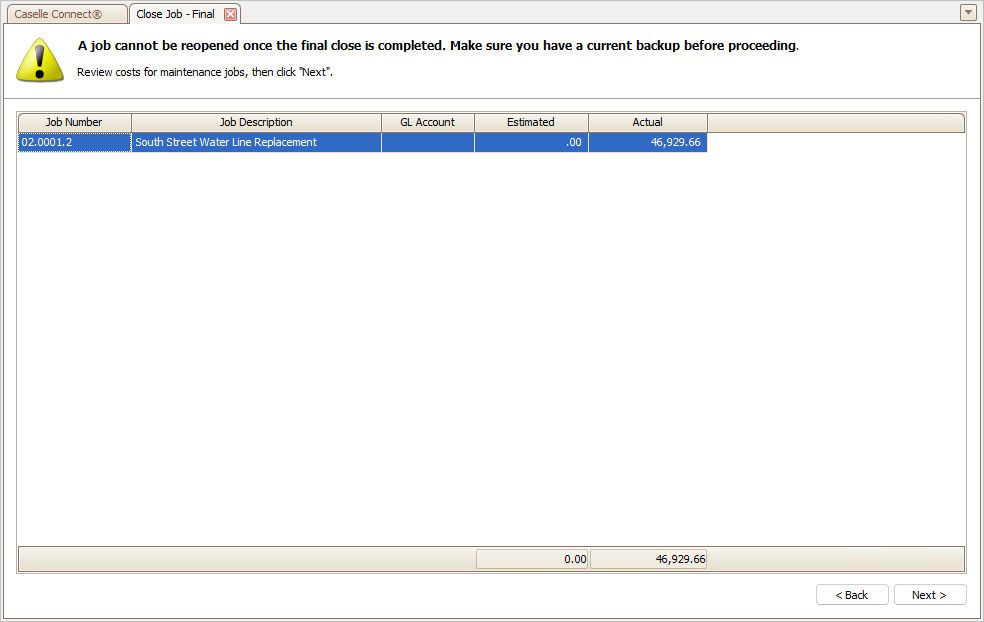

Step 4. Review costs for maintenance jobs

Costs for maintenance jobs incurred while performing maintenance-related work on assets, equipment, or infrastructure. Examples: Labor costs, materials and supplies, equipment costs, subcontractor and vendor costs, travel and transportation, permits and compliance costs, and overhead and administrative costs (allocated costs).





Are the costs correct?

  • Yes, the costs for maintenance jobs are correct. Click .

  • No, the costs for removal jobs are NOT correct. Use Connect Project Accounting > Jobs > Modify Existing Jobs to enter the correct amounts. Then, click Reload Data  (CTRL+R) to update the information in Close Jobs - Final.

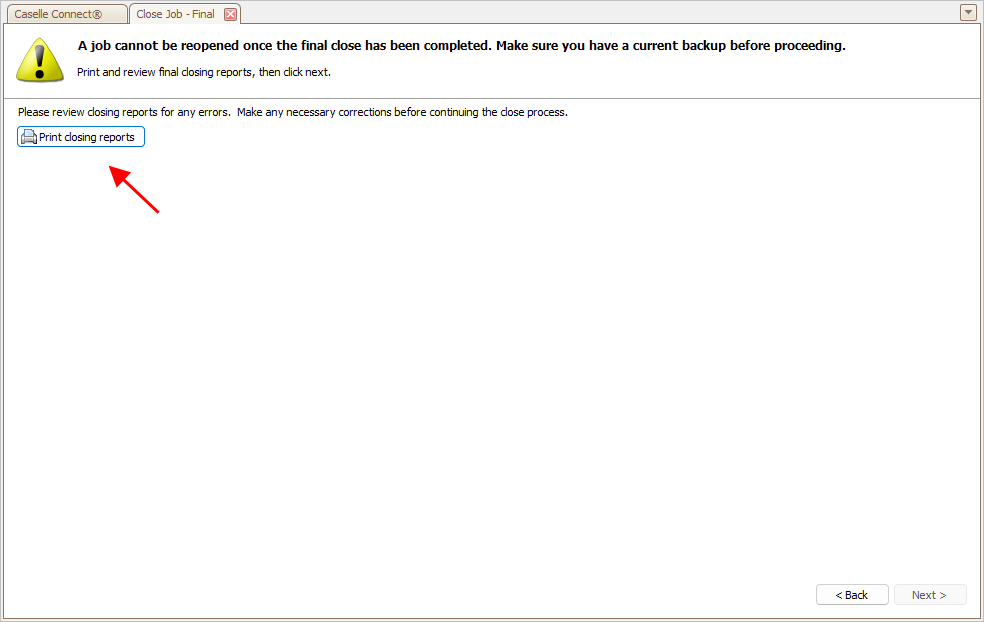

Step 5: Print and review closing reports

Print the final closing reports. Review the reports carefully. If you find any errors, you should correct them before you continue.

Click .

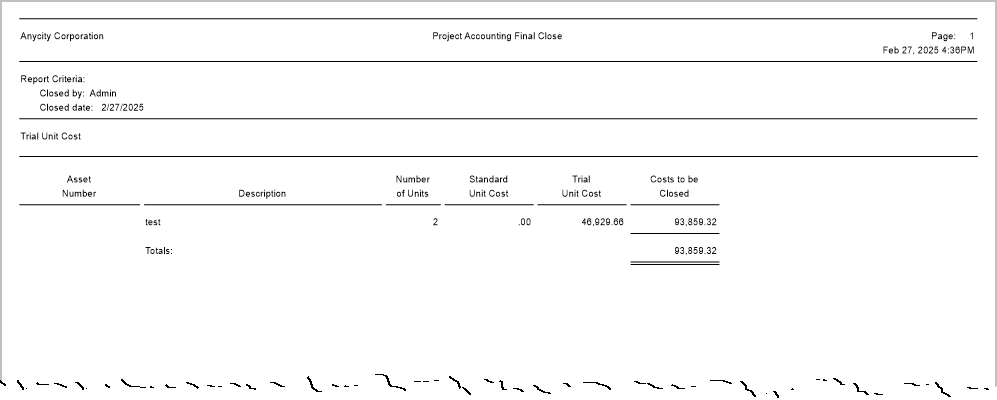

The closing report will print the asset, number of units, standard unit cost, trial unit cost, and costs to be closed. Review the report carefully.







Are the amounts on the closing reports correct?

  • Yes, the amounts on the closing reports are correct. Click .

  • No, the amounts on the closing reports are NOT correct. Stop! You need to enter the correct amounts before you continue (Jobs >Modify Existing Jobs). Then, click Reload Data  (CTRL+R), and then reprint the closing reports to check for errors again.

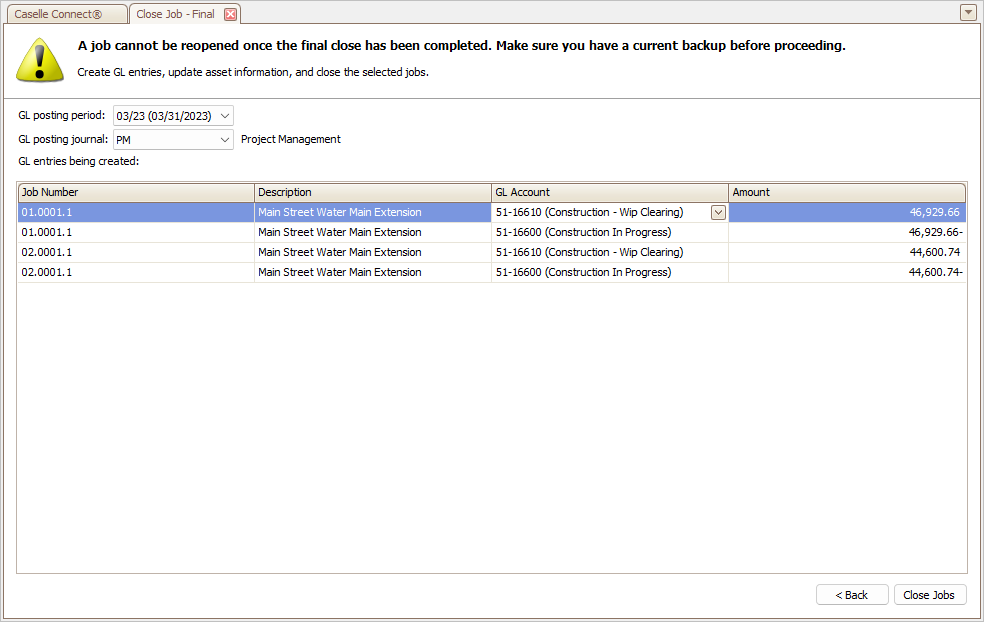

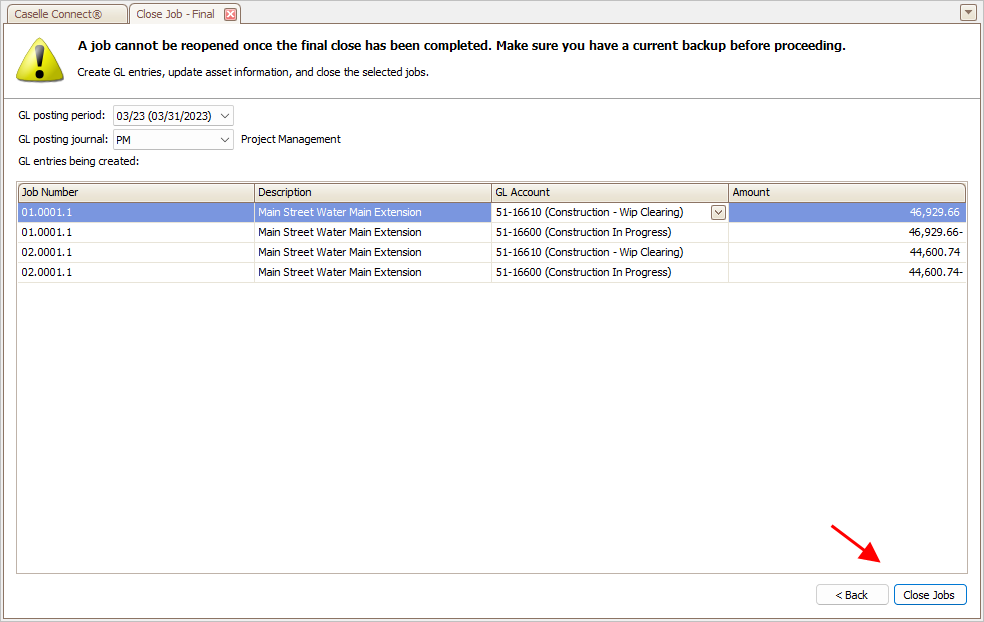

Step 6. Create GL entries, update asset information, and close the selected jobs

This is the last step to final closing a job.






GL posting period

Select the GL posting period to use to create the GL entries. Example: MM/YY (MM/DD/YYYY). If the GL interface is set to None, the GL posting period and GL posting journal fields will not be available.


GL posting journal

Select the GL posting journal to use to create GL entries. Example: PM (Project Management). If the GL interface is set to None, the GL posting period and GL posting journal fields will not be available.


GL entries being created

The transaction grid shows the job number, description, GL account that will be used to create the GL entry, and the entry amount. You can cahnge the GL account if needed by clicking on the GL account and selecting a new GL account from the menu.




Step 7. Close jobs



Click








    • Related Articles

    • How do I preliminary close a job?

      A preliminary close is the first step in the job closing process. During the preliminary close you can review and make corrections to the job. On the other hand, when a job is in final close you cannot make any changes to the job. You would ...
    • How do I reopen a preliminary closed job?

      Use Reopen Jobs to make jobs that have been preliminary closed accessible for editing. If the job is final closed you cannot use this routine to reopen it. You would reopen a preliminary closed job when additional work, costs, or corrections need to ...
    • Job Status Report

      A Job Status Report is a report that displays the current status and progress of jobs or projects. The report typically includes information such as job numbers, descriptions, statuses, start and completion dates, budgets, and completion progress. ...
    • Job Detail Report

      You would print the Job Detail Report to review detailed information about a specific job or group of jobs. The report typically includes job descriptions, statuses, budgets, costs, phases, cost codes, and transaction activity. Printing the report ...
    • Master Job Actual Costs Report

      A master job is another tool for dividing and grouping jobs based on their shared similarities. Use the Master Job Actual Costs Report to print a list of actual costs for open or closed master jobs. A Master Job Actual Costs Report is a comprehensive ...
